AfrOil                                PROJECTS & COMPANIES                                             AfrOil



                         Rubis attributed the gap in fuel supply to various   The firm’s tabulation shows 86% of products
                         factors including a spike in local demand over   were located to sales in Kenya in January 2022
                         the past three months. It showed that its local   and 14 % to export sales. It allocated 87% to local
                         daily retail sales had grown by 6.9 % in February,   sales in February,  81% in March, and 88% in
                         9.4% in March and 13.3 % in April from January   April, it said.
                         2022.                                  “Our efforts have gone a step further to
                           “Rubis Energy Kenya wishes to clarify that   ensure our Nairobi Depot was open during the
                         we have an allocation of over 80% dedicated to   weekend of April 2 to 3 to enable the delivery of
                         the local market; the balance to a maximum of   fuel to service stations and shall open as neces-
                         20% is exported to our subsidiaries in Uganda,   sary to continue facilitating loading and delivery
                         Rwanda and export customers,” the firm said.  of fuel to stations,” said Rubis. ™


       TotalEnergies moving to restart work




       on Mozambique LNG, Cabo Ligado says






          MOZAMBIQUE     FRENCH energy giant TotalEnergies is report-  700,000 have been displaced, but some of are
                         edly quietly beginning to resume operations   gradually returning as Mozambique’s army and
                         at its $20bn LNG project in northern Mozam-  troops from Rwanda, South Africa, Zimbabwe
                         bique, a year after halting work due to an Isla-  and other southern African countries regain
                         mist insurgency in the Cabo Delgado province.  territory from the insurgents.
                           According to the March 2022 edition of Cabo   TotalEnergies, Cabo Ligado reports, is fac-
                         Ligado, an observatory launched by two local   ing an additional challenge related to resettling
                         media houses and the Armed Conflict Location   communities affected by the project and others
                         & Event Data Project to monitor violence in that   who settled themselves near the project site. The
                         country, South African contractors are back at   company could eventually pay for the rehabili-
                         work while local employees who lost their jobs   tation of one of the settlements where villagers
                         last year are being rehired.         have sought shelter. The area is defended by
                           “[At] the main camp in Afungi, South   Rwandan troops.
                         African contractors are now working on the   Another challenge for the restart is the pre-
                         premises to meet new security requirements to   vailing insecurity in adjacent districts that are
                         protect the LNG project workforce. Workers laid   supposed to be defended by a regional force,
                         off last year, after the shutdown of the project,   which reportedly lacks personnel and hardware.
                         are now being offered new contracts to return,   A $2.4bn redevelopment plan created by the
                         mainly in social services and community-re-  government and supported by donors among
                         lated activities,” Fernando Lima, a journalist and   them the United Nations, World Bank, the
                         political commentator on Mozambique wrote in   European Union and the African Development
                         Cabo Ligado.                         Bank is proving ineffective, said Cabo Ligado,
                           TotalEnergies is the operator in a consortium   owing to disagreements among ministers about
                         that is investing to tap natural gas off Mozam-  the origins and motivations of the insurgency.
                         bique’s coast to an onshore processing facil-  The government says the rebellion was
                         ity. The $20bn project plans to produce 12mn   caused by external forces, including separatist
                         tonnes per year 9tpy) of LNG, mainly for export   groups linked to Islamic State (Daesh), while
                         to Europe and Asia.                  some observers blame social factors such as
                           The newsletter says Mozambique and   poverty and ethnic differences. ™
                         TotalEnergies agree that market constraints
                         created by Russia’s invasion of Ukraine in Feb-
                         ruary are creating additional pressure for work
                         to resume.
                           Maxime Rabilloud, TotalEnergies’ country
                         manager in Mozambique, recently noted “sig-
                         nificant improvements in the security situation.”
                         But he also said conditions were still not good
                         enough for the project to resume. “We cannot
                         place the lives of our workers in danger,” Rabil-
                         loud was quoted as saying by Cabo Ligado.
                           The Islamist inusrgency that started in
                         October 2017 has resulted in the death of some

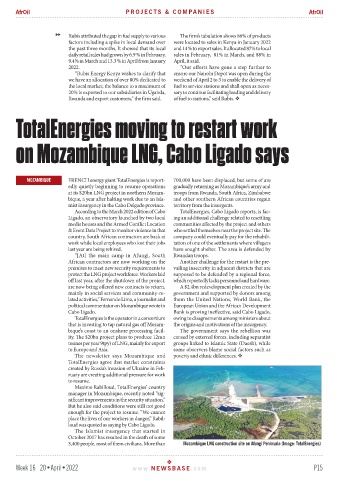

                         3,400 people, most of them civilians. More than   Mozambique LNG construction site on Afungi Peninsula (Image: TotalEnergies)
