AsianOil                                        OCEANIA                                             AsianOil

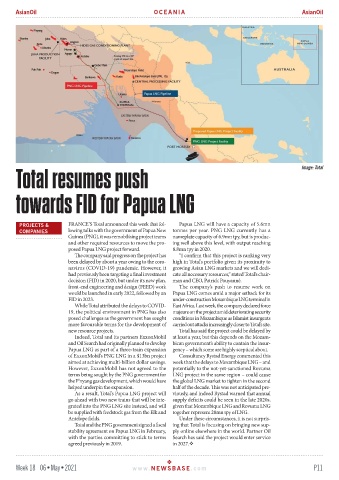

       Total resumes push                                                                                  Image: Total




       towards FID for Papua LNG





        PROJECTS &       FRANCE’S Total announced this week that fol-  Papua LNG will have a capacity of 5.6mn
        COMPANIES        lowing talks with the government of Papua New  tonnes per year. PNG LNG currently has a
                         Guinea (PNG), it was remobilising project teams  nameplate capacity of 6.9mn tpy, but is produc-
                         and other required resources to move the pro-  ing well above this level, with output reaching
                         posed Papua LNG project forward.     8.8mn tpy in 2020.
                           The company said progress on the project has   “I confirm that this project is ranking very
                         been delayed by about a year owing to the coro-  high in Total’s portfolio given its proximity to
                         navirus (COVID-19) pandemic. However, it  growing Asian LNG markets and we will dedi-
                         had previously been targeting a final investment  cate all necessary resources,” stated Total’s chair-
                         decision (FID) in 2020, but under its new plan,  man and CEO, Patrick Pouyanné.
                         front-end engineering and design (FEED) work   The company’s push to resume work on
                         would be launched in early 2022, followed by an  Papua LNG comes amid a major setback for its
                         FID in 2023.                         under-construction Mozambique LNG terminal in
                           While Total attributed the delays to COVID-  East Africa. Last week, the company declared force
                         19, the political environment in PNG has also  majeure on the project amid deteriorating security
                         posed challenges as the government has sought  conditions in Mozambique as Islamist insurgents
                         more favourable terms for the development of  carried out attacks increasingly closer to Total’s site.
                         new resource projects.                 Total has said the project could be delayed by
                           Indeed, Total and its partners ExxonMobil  at least a year, but this depends on the Mozam-
                         and Oil Search had originally planned to develop  bican government’s ability to contain the insur-
                         Papua LNG as part of a three-train expansion  gency – which some are highly sceptical about.
                         of ExxonMobil’s PNG LNG in a $13bn project   Consultancy Rystad Energy commented this
                         aimed at achieving multi-billion dollar savings.  week that the delays to Mozambique LNG – and
                         However, ExxonMobil has not agreed to the  potentially to the not-yet-sanctioned Rovuma
                         terms being sought by the PNG government for  LNG project in the same region – could cause
                         the P’nyang gas development, which would have  the global LNG market to tighten in the second
                         helped underpin the expansion.       half of the decade. This was not anticipated pre-
                           As a result, Total’s Papua LNG project will  viously, and indeed Rystad warned that annual
                         go ahead with two new trains that will be inte-  supply deficits could be seen in the late 2020s,
                         grated into the PNG LNG site instead, and will  given that Mozambique LNG and Rovuma LNG
                         be supplied with feedstock gas from the Elk and  together represent 28mn tpy of LNG.
                         Antelope fields.                       Under these circumstances, it is not surpris-
                           Total and the PNG government signed a fiscal  ing that Total is focusing on bringing new sup-
                         stability agreement on Papua LNG in February,  ply online elsewhere in the world. Partner Oil
                         with the parties committing to stick to terms  Search has said the project would enter service
                         agreed previously in 2019.           in 2027.™
