Page 41 - Gi flipbook_May 2019
P. 41

igem news – events

                 THE RIVER CROSSING PUZZLE


















                                                                                              PHIL CROFT, DETAILING THE ENGINEERING AND
                                                                                             LOGISTICAL CHALLENGES OF THIS VITAL PROJECT










                                                                                          TOMMY KNOTT (LEFT) THANKING PHIL CROFT (CENTRE)
                                                                                         WITH YORKSHIRE GAS PRESIDENT BARNEY DANIELS (RIGHT)











                                                                                             PHIL TAKING QUESTIONS FROM AN AUDIENCE OF

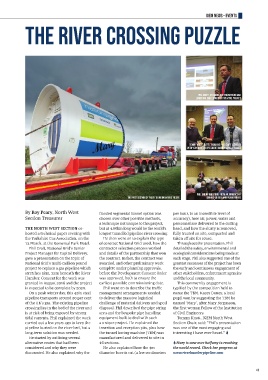

                                                               THE FIRST SECTION OF ‘MARY’ BEING DELIVERED TO SITE  AROUND 50 IGEM AND YGA MEMBERS


                 By Roy Peary, North West         flooded segmental tunnel option was   per hour, to an incredible level of
                 Section Treasurer                chosen over other possible methods,   accuracy), how air, power, water and
                                                  a technique not unique to this project,   personnel are delivered to the cutting
                 THE NORTH WEST SECTION co-       but at 4.86km long would be the world’s   head, and how the slurry is removed,
                 hosted a technical paper evening with   longest tunnelled pipeline river crossing.  fully treated on site, compacted and
                 the Yorkshire Gas Association, on the   He then went on to explain the type   taken off site for reuse.
                 13 March, at the Gomersal Park Hotel.  of contract National Grid used, how the   Throughout the presentation, Phil
                   Phil Croft, National Grid’s Senior   contractor selection process worked   detailed the safety, environmental and
                 Project Manager for Capital Delivery,   and details of the partnership that won   ecological considerations being made at
                 gave a presentation on the topic of   the contract. In fact, the contract was   each stage. Phil also suggested one of the
                 National Grid’s multi-million pound   awarded, and other preliminary work   greatest successes of the project has been
                 project to replace a gas pipeline which   complete under planning approvals,   the early and continuous engagement of
                 stretches 5km, 35m beneath the River   before the Development Consent Order   other stakeholders, enforcement agencies
                 Humber. Consent for the work was   was approved, both to ensure the   and the local community.
                 granted in August 2016 and the project   earliest possible commissioning date.  This community engagement is
                 is expected to be complete by 2020.  Phil went on to describe the traffic   typified by the competition held to
                   On a peak winter day, this 42in steel   management arrangements needed   name the TBM. Kacey Doney, a local
                 pipeline transports around 20 per cent   to deliver the massive logistical   pupil won by suggesting the TBM be
                 of the UK’s gas. The existing pipeline   challenge of material delivery and spoil   named ‘Mary’, after Mary Fergusson,
                 crossing lies in the bed of the river and   disposal. Phil described the pipe string   the first woman Fellow of the Institution
                 is at risk of being exposed by strong   area and the bespoke pipe handling   of Civil Engineers.
                 tidal currents. Phil explained the work   equipment built to deal with such   Tommy Knott, IGEM North West
                 carried out a few years ago to keep the   a unique project. He explained the   Section Chair, said: “Phil’s presentation
                 pipeline buried on the river bed, but a   insertion and reception pits, plus how   was one of the most engaging and
                 long-term solution was needed.   the tunnel boring machine (TBM) was   interesting I have ever heard.”
                   He started by outlining several   manufactured and delivered to site in
                 alternative routes that had been   16 sections.                     Mary is now over halfway to reaching
                 considered and why they were       He also explained how the 4m   the world record. Check her progress at
                 discounted. He also explained why the   diameter bore is cut (a few centimetres   www.riverhumberpipeline.com



                                                                                                                        41



        IGEMNews_Events.indd   2                                                                                  16/04/2019   18:49
