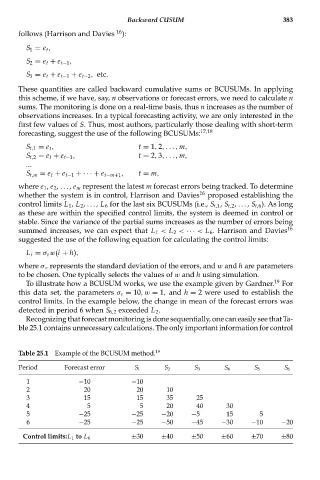

                                   Backward CUSUM                            383
      follows (Harrison and Davies  16 ):
        S 1 = e t ,
        S 2 = e t + e t−1 ,
        S 3 = e t + e t−1 + e t−2 , etc.
      These quantities are called backward cumulative sums or BCUSUMs. In applying
      this scheme, if we have, say, n observations or forecast errors, we need to calculate n
      sums. The monitoring is done on a real-time basis, thus n increases as the number of
      observations increases. In a typical forecasting activity, we are only interested in the
      first few values of S. Thus, most authors, particularly those dealing with short-term
      forecasting, suggest the use of the following BCUSUMs: 17,18
        S t,1 = e t ,                 t = 1, 2,..., m,
        S t,2 = e t + e t−1 ,         t = 2, 3,..., m,
        ...
        S t,m = e t + e t−1 +· · · + e t−m+1 ,  t = m,
      where e 1 , e 2 , . .., e m represent the latest m forecast errors being tracked. To determine
      whether the system is in control, Harrison and Davies 16  proposed establishing the
      control limits L 1 , L 2 , . .., L 6 for the last six BCUSUMs (i.e., S t,1 , S t,2 ,. . . , S t,6 ). As long
      as these are within the specified control limits, the system is deemed in control or
      stable. Since the variance of the partial sums increases as the number of errors being
      summed increases, we can expect that L 1 < L 2 < ··· < L 6 . Harrison and Davies 16
      suggested the use of the following equation for calculating the control limits:
        L i = σ ε w(i + h),
      where σ ε represents the standard deviation of the errors, and w and h are parameters
      to be chosen. One typically selects the values of w and h using simulation.
        To illustrate how a BCUSUM works, we use the example given by Gardner. 19  For
      this data set, the parameters σ ε = 10,w = 1, and h = 2 were used to establish the
      control limits. In the example below, the change in mean of the forecast errors was
      detected in period 6 when S 6,2 exceeded L 2 .
        Recognizing that forecast monitoring is done sequentially, one can easily see that Ta-
      ble 25.1 contains unnecessary calculations. The only important information for control


      Table 25.1 Example of the BCUSUM method. 19

      Period      Forecast error     S 1     S 2      S 3     S 4     S 5     S 6
        1             −10            −10
        2               20            20      10
        3               15            15      35      25
        4                5             5      20      40      30
        5             −25            −25     −20     −5       15       5
        6             −25            −25     −50     −45     −30     −10     −20
                                     ±30     ±40     ±50     ±60     ±70     ±80
       Control limits:L 1 to L 6
