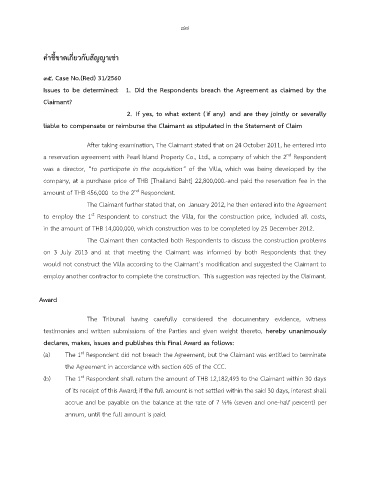

               ค าชี้ขาดเกี่ยวกับสัญญาเช่า


               35. Case No.(Red) 31/2560

               Issues to be determined:  1.   Did the Respondents breach the Agreement as claimed by the
               Claimant?
                                           2.   If yes, to what extent (if any)   and are they jointly or severally

               liable to compensate or reimburse the Claimant as stipulated in the Statement of Claim


                              After taking examination, The Claimant stated that on 24 October 2011, he entered into
                                                                                                nd
               a reservation agreement with Pearl Island Property Co., Ltd., a company of which the 2  Respondent
               was a director, “to participate in the acquisition” of the Villa, which was being developed by the
               company, at a purchase price of THB [Thailand Baht] 22,800,000.-and paid the reservation fee in the

                                             nd
               amount of THB 456,000  to the 2  Respondent.
                              The Claimant further stated that, on  January 2012, he then entered into the Agreement

               to employ the 1  Respondent to construct the Villa, for the construction price, included all costs,
                               st
               in the amount of THB 14,000,000, which construction was to be completed by 25 December 2012.
                              The Claimant then contacted both Respondents to discuss the construction problems

               on  3 July  2013  and  at  that  meeting  the  Claimant  was informed  by both  Respondents that  they
               would not construct the Villa according to the Claimant’s modification and suggested the Claimant to

               employ another contractor to complete the construction.  This suggestion was rejected by the Claimant.


              Award


                              The  Tribunal  having  carefully  considered  the  documentary  evidence,  witness
               testimonies and written submissions of the Parties and given weight thereto, hereby unanimously

               declares, makes, issues and publishes this Final Award as follows:
               (a)     The 1  Respondent did not breach the Agreement, but the Claimant was entitled to terminate
                            st
                       the Agreement in accordance with section 605 of the CCC.

                            st
               (b)     The 1  Respondent shall return the amount of THB 12,182,493 to the Claimant within 30 days
                       of its receipt of this Award; if the full amount is not settled within the said 30 days, interest shall

                       accrue and be payable on the balance at the rate of 7 ½% (seven and one-half percent) per
                       annum, until the full amount is paid.
