Answers to supplementary objective test questions




               CHAPTER 15 – PROJECT MANAGEMENT TOOLS AND
               TECHNIQUES


               15.1 The correct statements are B, C and D.

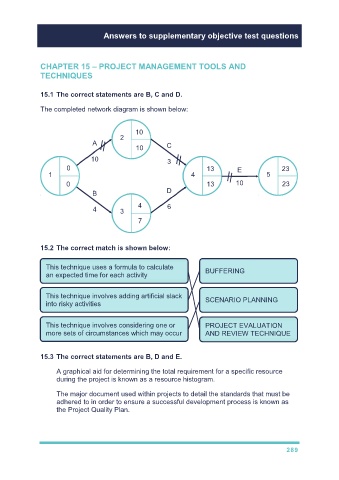

               The completed network diagram is shown below:



                                                 10
                                           2
                                 A                          C
                                                 10
                                 10                         3
                        0                                                 13        E               23
                  1                                                 4                          5
                        0                                                 13        10              23
                                 B                          D
                                                  4         6
                                  4        3

                                                  7



               15.2 The correct match is shown below:


                 This technique uses a formula to calculate              BUFFERING
                 an expected time for each activity


                 This technique involves adding artificial slack         SCENARIO PLANNING
                 into risky activities


                 This technique involves considering one or              PROJECT EVALUATION
                 more sets of circumstances which may occur              AND REVIEW TECHNIQUE


               15.3 The correct statements are B, D and E.


                     A graphical aid for determining the total requirement for a specific resource
                     during the project is known as a resource histogram.


                     The major document used within projects to detail the standards that must be
                     adhered to in order to ensure a successful development process is known as
                     the Project Quality Plan.
