Page 17 - Gi_April2020
P. 17

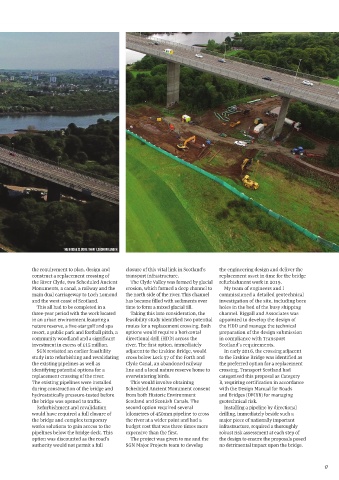

THE BRIDGE IS MORE THAN 1,300M IN LENGTH


                 the requirement to plan, design and   closure of this vital link in Scotland’s   the engineering design and deliver the
                 construct a replacement crossing of   transport infrastructure.   replacement asset in time for the bridge
                 the River Clyde, two Scheduled Ancient   The Clyde Valley was formed by glacial   refurbishment work in 2019.
                 Monuments, a canal, a railway and the   erosion, which formed a deep channel to   My team of engineers and I
                 main dual carriageway to Loch Lomond   the north side of the river. This channel   commissioned a detailed geotechnical
                 and the west coast of Scotland.   has become filled with sediments over   investigation of the site, including bore
                   This all had to be completed in a   time to form a mixed glacial till.   holes in the bed of the busy shipping
                 three-year period with the work located   Taking this into consideration, the   channel. Riggall and Associates was
                 in an urban environment featuring a   feasibility study identified two potential   appointed to develop the design of
                 nature reserve, a five-star golf and spa   routes for a replacement crossing. Both   the HDD and manage the technical
                 resort, a public park and football pitch, a   options would require a horizontal   preparation of the design submission
                 community woodland and a significant   directional drill (HDD) across the   in compliance with Transport
                 investment in excess of £15 million.  river. The first option, immediately   Scotland’s requirements.
                   SGN revisited an earlier feasibility   adjacent to the Erskine Bridge, would   In early 2016, the crossing adjacent
                 study into refurbishing and revalidating   cross below Lock 57 of the Forth and   to the Erskine Bridge was identified as
                 the existing pipelines as well as   Clyde Canal, an abandoned railway   the preferred option for a replacement
                 identifying potential options for a   line and a local nature reserve home to   crossing. Transport Scotland had
                 replacement crossing of the river.   overwintering birds.         categorised this proposal as Category
                 The existing pipelines were installed   This would involve obtaining   B, requiring certification in accordance
                 during construction of the bridge and   Scheduled Ancient Monument consent   with the Design Manual for Roads
                 hydrostatically pressure-tested before   from both Historic Environment   and Bridges (DMRB) for managing
                 the bridge was opened to traffic.   Scotland and Scottish Canals. The   geotechnical risk.
                   Refurbishment and revalidation   second option required several   Installing a pipeline by directional
                 would have required a full closure of   kilometres of 450mm pipeline to cross   drilling, immediately beside such a
                 the bridge and complex temporary   the river at a wider point and had a   major piece of nationally important
                 works solutions to gain access to the   budget cost that was three times more   infrastructure, required a thoroughly
                 pipelines below the bridge deck. This   expensive than the first.   robust risk assessment at each step of
                 option was discounted as the road’s   The project was given to me and the   the design to ensure the proposals posed
                 authority would not permit a full   SGN Major Projects team to develop   no detrimental impact upon the bridge.



                                                                                                                        17
