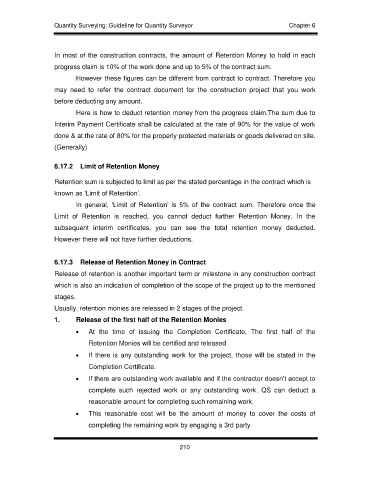

Quantity Surveying: Guideline for Quantity Surveyor                                                         Chapter 6



                   In most of the construction contracts, the amount of Retention Money to hold in each
                   progress claim is 10% of the work done and up to 5% of the contract sum.
                          However these figures can be different from contract to contract. Therefore you

                   may  need  to  refer  the  contract  document  for  the  construction  project  that  you  work
                   before deducting any amount.
                          Here is how to deduct retention money from the progress claim.The sum due to

                   Interim Payment Certificate shall be calculated at the rate of 90% for the value of work
                   done & at the rate of 80% for the properly protected materials or goods delivered on site.

                   (Generally)

                   6.17.2    Limit of Retention Money

                   Retention sum is subjected to limit as per the stated percentage in the contract which is
                   known as ‘Limit of Retention’.

                          In  general,  ‘Limit  of  Retention’  is  5%  of  the  contract  sum.  Therefore  once  the
                   Limit  of  Retention  is  reached,  you  cannot  deduct  further  Retention  Money.  In  the
                   subsequent  interim  certificates,  you  can  see  the  total  retention  money  deducted.
                   However there will not have further deductions.


                   6.17.3    Release of Retention Money in Contract

                   Release of retention is another important term or milestone in any construction contract
                   which is also an indication of completion of the scope of the project up to the mentioned
                   stages.

                   Usually, retention monies are released in 2 stages of the project.
                   1.     Release of the first half of the Retention Monies

                             At  the  time  of  issuing  the  Completion  Certificate,  The  first  half  of  the
                              Retention Monies will be certified and released
                             If there is any outstanding work for the project, those will be stated in  the

                              Completion Certificate.
                             If there are outstanding work available and if the contractor doesn’t accept to

                              complete  such  rejected  work  or  any  outstanding  work,  QS  can  deduct  a
                              reasonable amount for completing such remaining work.
                             This  reasonable  cost  will  be  the  amount  of  money  to  cover  the  costs  of

                              completing the remaining work by engaging a 3rd party.
