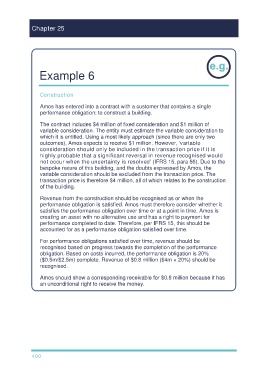

Chapter 25









                   Example 6




                   Construction


                   Amos has entered into a contract with a customer that contains a single
                   performance obligation: to construct a building.


                   The contract includes $4 million of fixed consideration and $1 million of
                   variable consideration. The entity must estimate the variable consideration to
                   which it is entitled. Using a most likely approach (since there are only two
                   outcomes), Amos expects to receive $1 million. However, ‘variable
                   consideration should only be included in the transaction price if it is
                   highly probable that a significant reversal in revenue recognised would
                   not occur when the uncertainty is resolved’ (IFRS 15, para 56). Due to the
                   bespoke nature of this building, and the doubts expressed by Amos, the
                   variable consideration should be excluded from the transaction price. The
                   transaction price is therefore $4 million, all of which relates to the construction
                   of the building.

                   Revenue from the construction should be recognised as or when the
                   performance obligation is satisfied. Amos must therefore consider whether it
                   satisfies the performance obligation over time or at a point in time. Amos is
                   creating an asset with no alternative use and has a right to payment for
                   performance completed to date. Therefore, per IFRS 15, this should be
                   accounted for as a performance obligation satisfied over time.

                   For performance obligations satisfied over time, revenue should be
                   recognised based on progress towards the completion of the performance
                   obligation. Based on costs incurred, the performance obligation is 20%
                   ($0.5m/$2.5m) complete. Revenue of $0.8 million ($4m × 20%) should be
                   recognised.

                   Amos should show a corresponding receivable for $0.8 million because it has
                   an unconditional right to receive the money.
