Page 29 - Basic PD Theory
P. 29

PD Data Types


               3.4.2.2.1   Differential (PDA)
               In hydro-generators, coupler pairs are placed on each phase and the length of the coaxial cables are adjusted in such a way that

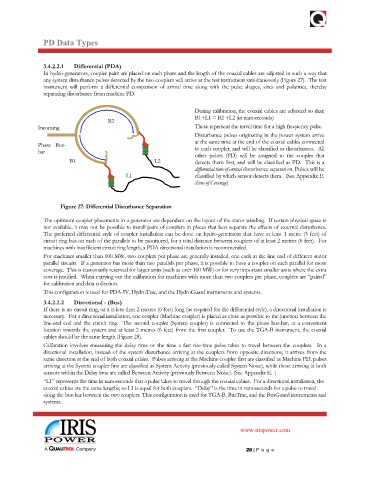

               any system disturbance pulses detected by the two couplers will arrive at the test instrument simultaneously (Figure 27).  The test
               instrument will  perform a differential  comparison  of arrival time along with  the pulse  shapes,  sizes and polarities,  thereby
               separating disturbance from machine PD.

                                                                 During calibration, the coaxial cables are adjusted so that:
                                                                 B1+L1 = B2 +L2 (in nanoseconds)
                                     B2
              Incoming                                           These represent the travel time for a high frequency pulse.
                                                                 Disturbance pulses originating in the power system arrive
              Phase Bus-                                         at the same time at the end of the coaxial cables connected
              bar                                                to each coupler, and will be classified as disturbances.  All
                                                                 other pulses (PD) will be assigned to the  coupler that
                         B1                         L2           detects them first, and will be classified as PD.  This is a
                                                                 differential time-of-arrival disturbance separation. Pulses will be
                                           L1                    classified by which sensor detects them.  (See Appendix E.
                                                                 Zone of Coverage)


                     Figure 27: Differential Disturbance Separation

               The optimum coupler placements in a generator are dependent on the layout of the stator winding.  If certain physical space is
               not available, it may not be possible to install pairs of couplers in places that best separate the effects of external disturbance.
               The preferred differential style of coupler installation can be done on hydro-generators that have at least 1 metre (3 feet) of
               circuit ring bus on each of the parallels to be monitored, for a total distance between couplers of at least 2 metres (6 feet).  For
               machines with insufficient circuit ring length, a PDA directional installation is recommended.
               For machines smaller than 100 MW, two couplers per phase are generally installed, one each at the line end of different stator
               parallel circuits.  If a generator has more than two parallels per phase, it is possible to have a coupler on each parallel for more
               coverage.  This is customarily reserved for larger units (such as over 100 MW) or for very important smaller units where the extra
               cost is justified.  When carrying out the calibration for machines with more than two couplers per phase, couplers are “paired”
               for calibration and data collection.
               This configuration is used for PDA-IV, HydroTrac, and the HydroGuard instruments and systems.

               3.4.2.2.2   Directional - (Bus)
               If there is no circuit ring, or it is less than 2 metres (6 feet) long (as required for the differential style), a directional installation is
               necessary.  For a directional installation, one coupler (Machine coupler) is placed as close as possible to the junction between the
               line-end coil and the circuit ring.  The second coupler (System coupler) is connected to the phase bus-bar, at a convenient
               location towards the system and at least 2 metres (6 feet) from the first coupler.  To use the TGA-B instrument, the coaxial
               cables should be the same length (Figure 28).
               Calibration involves measuring the delay time or the time a fast rise-time pulse takes to travel between the couplers.  In a
               directional installation, instead of the system disturbance arriving at the couplers from opposite directions, it arrives from the
               same direction at the end of both coaxial cables.  Pulses arriving at the Machine coupler first are classified as Machine PD, pulses
               arriving at the System coupler first are classified as System Activity (previously called System Noise), while those arriving at both
               sensors within the Delay time are called Between Activity (previously Between Noise). (See Appendix E.  )
               “L1” represents the time in nanoseconds that a pulse takes to travel through the coaxial cables.  For a directional installation, the
               coaxial cables are the same lengths; so L1 is equal for both couplers.  “Delay” is the time in nanoseconds for a pulse to travel
               along the bus-bar between the two couplers. This configuration is used for TGA-B, BusTrac, and the BusGuard instruments and
               systems.
