Page 124 - GM E-booklet 2022-23
P. 124

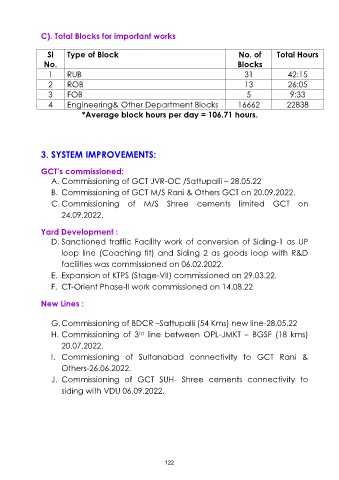

C). Total Blocks for important works
Sl Type of Block No. of Total Hours
No. Blocks
1 RUB 31 42:15
2 ROB 13 26:05
3 FOB 5 9:33
4 Engineering& Other Department Blocks 16662 22838
*Average block hours per day = 106.71 hours.
3. SYSTEM IMPROVEMENTS:
GCT’s commissioned:
A. Commissioning of GCT JVR-OC /Sattupalli – 28.05.22
B. Commissioning of GCT M/S Rani & Others GCT on 20.09.2022.
C. Commissioning of M/S Shree cements limited GCT on
24.09.2022.
Yard Development :
D. Sanctioned traffic Facility work of conversion of Siding-1 as UP
loop line (Coaching fit) and Siding 2 as goods loop with R&D
facilities was commissioned on 06.02.2022.
E. Expansion of KTPS (Stage-VII) commissioned on 29.03.22.
F. CT-Orient Phase-II work commissioned on 14.08.22
New Lines :
G. Commissioning of BDCR –Sattupalli (54 Kms) new line-28.05.22
H. Commissioning of 3 line between OPL-JMKT – BGSF (18 kms)
rd
20.07.2022.
I. Commissioning of Sultanabad connectivity to GCT Rani &
Others-26.06.2022.
J. Commissioning of GCT SUH- Shree cements connectivity to
siding with VDU 06.09.2022.
122
