Page 126 - GM E-booklet 2022-23
P. 126

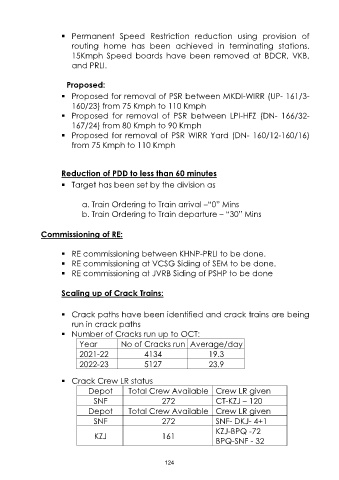

Permanent Speed Restriction reduction using provision of
routing home has been achieved in terminating stations.
15Kmph Speed boards have been removed at BDCR, VKB,
and PRLI.
Proposed:
Proposed for removal of PSR between MKDI-WIRR (UP- 161/3-
160/23) from 75 Kmph to 110 Kmph
Proposed for removal of PSR between LPI-HFZ (DN- 166/32-
167/24) from 80 Kmph to 90 Kmph
Proposed for removal of PSR WIRR Yard (DN- 160/12-160/16)
from 75 Kmph to 110 Kmph
Reduction of PDD to less than 60 minutes
Target has been set by the division as
a. Train Ordering to Train arrival –“0” Mins
b. Train Ordering to Train departure – “30” Mins
Commissioning of RE:
RE commissioning between KHNP-PRLI to be done.
RE commissioning at VCSG Siding of SEM to be done.
RE commissioning at JVRB Siding of PSHP to be done
Scaling up of Crack Trains:
Crack paths have been identified and crack trains are being
run in crack paths
Number of Cracks run up to OCT:
Year No of Cracks run Average/day
2021-22 4134 19.3
2022-23 5127 23.9
Crack Crew LR status
Depot Total Crew Available Crew LR given
SNF 272 CT-KZJ – 120
Depot Total Crew Available Crew LR given
SNF 272 SNF- DKJ- 4+1
KZJ-BPQ -72
KZJ 161
BPQ-SNF - 32
124
