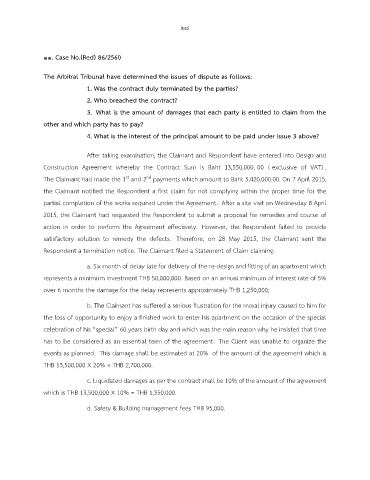

28



               11. Case No.(Red) 86/2560


               The Arbitral Tribunal have determined the issues of dispute as follows:
                              1. Was the contract duly terminated by the parties?

                              2. Who breached the contract?
                              3.   What is the amount of damages that each party is entitled to claim from the
               other and which party has to pay?

                              4. What is the interest of the principal amount to be paid under issue 3 above?


                              After taking examination, the Claimant and Respondent have entered into Design and
               Construction  Agreement  whereby  the  Contract  Sum  is  Baht  13,550,000. 00  ( exclusive  of  VAT) .

                                           st
               The Claimant had made the 1  and 2  payments which amount to Baht 5,420,000.00. On 7 April 2015,
                                                 nd
               the Claimant notified the Respondent a first claim for not complying within the proper time for the
               partial completion of the works required under the Agreement.   After a site visit on Wednesday 8 April
               2015, the Claimant had requested the Respondent to submit a proposal for remedies and course of

               action in order to perform the Agreement effectively.   However, the Respondent failed to provide
               satisfactory  solution  to  remedy  the  defects.   Therefore,  on  28  May  2015,  the  Claimant  sent  the
               Respondent a termination notice. The Claimant filed a Statement of Claim claiming:


                              a. Six month of delay late for delivery of the re-design and fitting of an apartment which
               represents a minimum investment THB 50,000,000. Based on an annual minimum of interest rate of 5%

               over 6 months the damage for the delay represents approximately THB 1,250,000;

                              b. The Claimant has suffered a serious frustration for the moral injury caused to him for
               the loss of opportunity to enjoy a finished work to enter his apartment on the occasion of the special

               celebration of his “special” 60 years birth day and which was the main reason why he insisted that time
               has to be considered as an essential term of the agreement.   The Client was unable to organize the

               events as planned.   This damage shall be estimated at 20%   of the amount of the agreement which is
               THB 13,500,000 X 20% = THB 2,700,000.

                              c. Liquidated damages as per the contract shall be 10% of the amount of the agreement

               which is THB 13,500,000 X 10% = THB 1,350,000.

                              d. Safety & Building management fees THB 95,000.
