P. 28

24

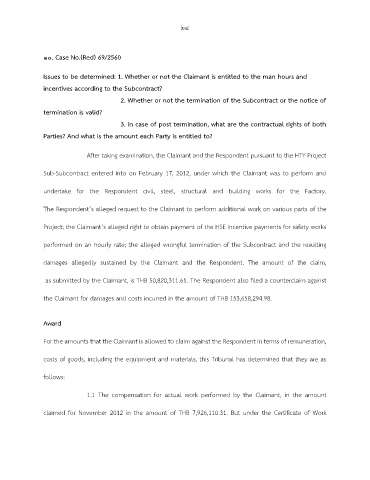

               10. Case No.(Red) 69/2560


               Issues to be determined: 1. Whether or not the Claimant is entitled to the man hours and
               incentives according to the Subcontract?

                                         2. Whether or not the termination of the Subcontract or the notice of
               termination is valid?
                                         3. In case of post termination, what are the contractual rights of both

               Parties? And what is the amount each Party is entitled to?


                              After taking examination, the Claimant and the Respondent pursuant to the HTY Project


               Sub-Subcontract entered into on February 17, 2012, under which the Claimant was to perform and

               undertake  for  the  Respondent  civil,  steel,  structural  and  building  works  for  the  Factory.


               The Respondent’s alleged request to the Claimant to perform additional work on various parts of the


               Project; the Claimant’s alleged right to obtain payment of the HSE incentive payments for safety works

               performed on an hourly rate; the alleged wrongful termination of the Subcontract and the resulting


               damages  allegedly  sustained  by  the  Claimant  and  the  Respondent.  The  amount  of  the  claim,


                as submitted by the Claimant, is THB 50,820,311.61. The Respondent also filed a counterclaim against

               the Claimant for damages and costs incurred in the amount of THB 153,658,294.98.




               Award

               For the amounts that the Claimant is allowed to claim against the Respondent in terms of remuneration,


               costs of goods, including the equipment and materials, this Tribunal has determined that they are as


               follows:

                              1.1 The compensation for actual work performed by the Claimant, in the amount


               claimed for November 2012 in the amount of THB 7,926,110.31. But under the Certificate of Work
