3

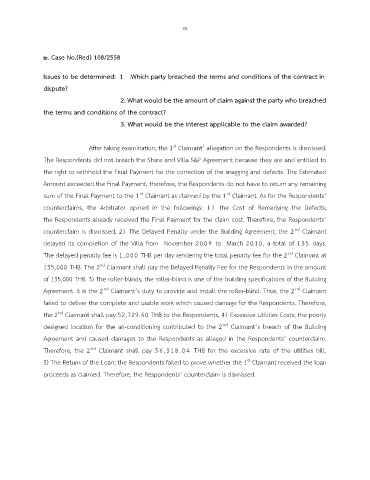

               2. Case No.(Red) 108/2558


               Issues to be determined:  1   .Which party breached the terms and conditions of the contract in
               dispute?

                                         2. What would be the amount of claim against the party who breached
               the terms and conditions of the contract?
                                         3. What would be the interest applicable to the claim awarded?


                                                          st
                               After taking examination, the 1  Claimant’ allegation on the Respondents is dismissed.
               The Respondents did not breach the Share and Villa S&P Agreement because they are and entitled to
               the right to withhold the Final Payment for the correction of the snagging and defects. The Estimated

               Amount exceeded the Final Payment, therefore, the Respondents do not have to return any remaining
                                               st
                                                                            st
               sum of the Final Payment to the 1  Claimant as claimed by the 1  Claimant. As for the Respondents’
               counterclaims,  the  Arbitrator  opined  in  the  followings:  1 )   the  Cost  of  Remedying  the  Defects;
               the Respondents already received the Final Payment for the claim cost. Therefore, the Respondents’
                                                                                                   nd
               counterclaim is dismissed, 2) The Delayed Penalty under the Building Agreement; the 2  Claimant
               delayed its completion of the Villa from  November 2 0 0 9  to  March 2 0 1 0 , a total of 1 3 5  days.

                                                                                                nd
               The delayed penalty fee is 1 , 0 0 0  THB per day rendering the total penalty fee for the 2  Claimant at
                                  nd
               135,000 THB. The 2  Claimant shall pay the Delayed Penalty Fee for the Respondents in the amount
               of 135,000 THB. 3) The roller-blinds; the roller-blind is one of the building specifications of the Building

               Agreement. It is the 2  Claimant’s duty to provide and install the roller-blind. Thus, the 2  Claimant
                                                                                                   nd
                                   nd
               failed to deliver the complete and usable work which caused damage for the Respondents. Therefore,
               the 2  Claimant shall pay 52,729.60 THB to the Respondents, 4) Excessive Utilities Costs; the poorly
                    nd
                                                                           nd
               designed location for the air-conditioning contributed to the 2  Claimant’s breach of the Building
               Agreement and caused damages to the Respondents as alleged in the Respondents’ counterclaim.
               Therefore, the 2  Claimant shall pay 5 6 , 3 1 8 . 0 4   THB for the excessive rate of the utilities bill.
                               nd
               5) The Return of the Loan; the Respondents failed to prove whether the 1  Claimant received the loan
                                                                                   st
               proceeds as claimed. Therefore, the Respondents’ counterclaim is dismissed.
