Page 200 - BASIC GUIDELINE FOR QS
P. 200

Quantity Surveying: Guideline for Quantity Surveyor                                                         Chapter 6

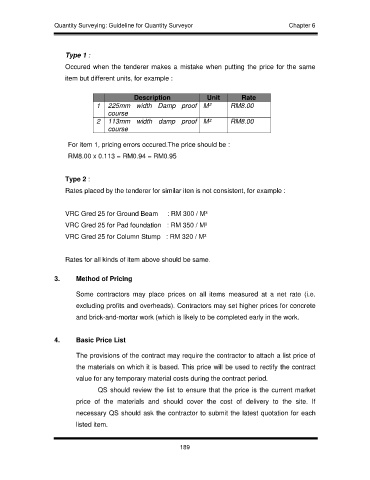

                       Type 1 :
                       Occured when the tenderer makes a mistake when putting the price for the same
                       item but different units, for example :


                                             Description              Unit       Rate
                                 1  225mm  width  Damp  proof  M²            RM8.00
                                     course
                                 2  113mm  width  damp  proof  M²            RM8.00
                                     course

                        For item 1, pricing errors occured.The price should be :
                        RM8.00 x 0.113 = RM0.94 = RM0.95


                       Type 2 :
                       Rates placed by the tenderer for similar iten is not consistent, for example :


                       VRC Gred 25 for Ground Beam     : RM 300 / M³

                       VRC Gred 25 for Pad foundation   : RM 350 / M³
                       VRC Gred 25 for Column Stump   : RM 320 / M³


                       Rates for all kinds of item above should be same.

                   3.     Method of Pricing

                          Some  contractors  may  place  prices  on  all  items  measured  at  a  net  rate  (i.e.
                          excluding profits and overheads). Contractors may set higher prices for concrete

                          and brick-and-mortar work (which is likely to be completed early in the work.

                   4.     Basic Price List

                          The provisions of the contract may require the contractor to attach a list price of

                          the materials on which it is based. This price will be used to rectify the contract
                          value for any temporary material costs during the contract period.

                                 QS should review the list to ensure that the price is the current market
                          price  of  the  materials  and  should  cover  the  cost  of  delivery  to  the  site.  If
                          necessary QS should ask the contractor to submit the latest quotation for each

                          listed item.
