Quantity Surveying: Guideline for Quantity Surveyor Chapter 6
Referring to Table Q.3.a and Table Q.3.b and assuming that Table Q.3.a is a complete
page contained in the bills of quantities. Describe the steps of correcting pricing errors
for concrete work by using RM187.00 as the new rate agreed upon for each cubic metre
concrete grade 20 to suspended floor slab, wall, column, beam, staircase and roof slab.

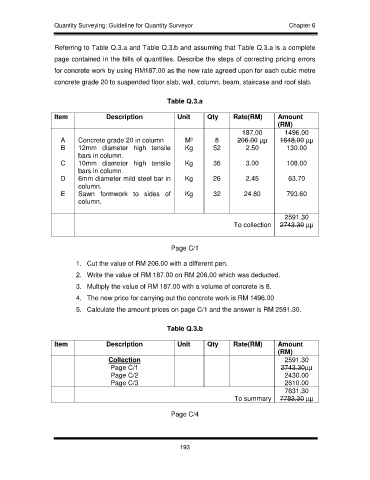

Table Q.3.a
Item Description Unit Qty Rate(RM) Amount
(RM)
187.00 1496.00
A Concrete grade 20 in column M³ 8 206.00 µµ 1648.00 µµ
B 12mm diameter high tensile Kg 52 2.50 130.00
bars in column.
C 10mm diameter high tensile Kg 36 3.00 108.00
bars in column.
D 6mm diameter mild steel bar in Kg 26 2.45 63.70
column.
E Sawn formwork to sides of Kg 32 24.80 793.60
column.
2591.30
To collection 2743.30 µµ
Page C/1
1. Cut the value of RM 206.00 with a different pen.
2. Write the value of RM 187.00 on RM 206.00 which was deducted.
3. Multiply the value of RM 187.00 with a volume of concrete is 8.
4. The new price for carrying out the concrete work is RM 1496.00
5. Calculate the amount prices on page C/1 and the answer is RM 2591.30.
Table Q.3.b
Item Description Unit Qty Rate(RM) Amount
(RM)
Collection 2591.30
Page C/1 2743.30µµ
Page C/2 2430.00
Page C/3 2610.00
7631.30
To summary 7783.30 µµ
